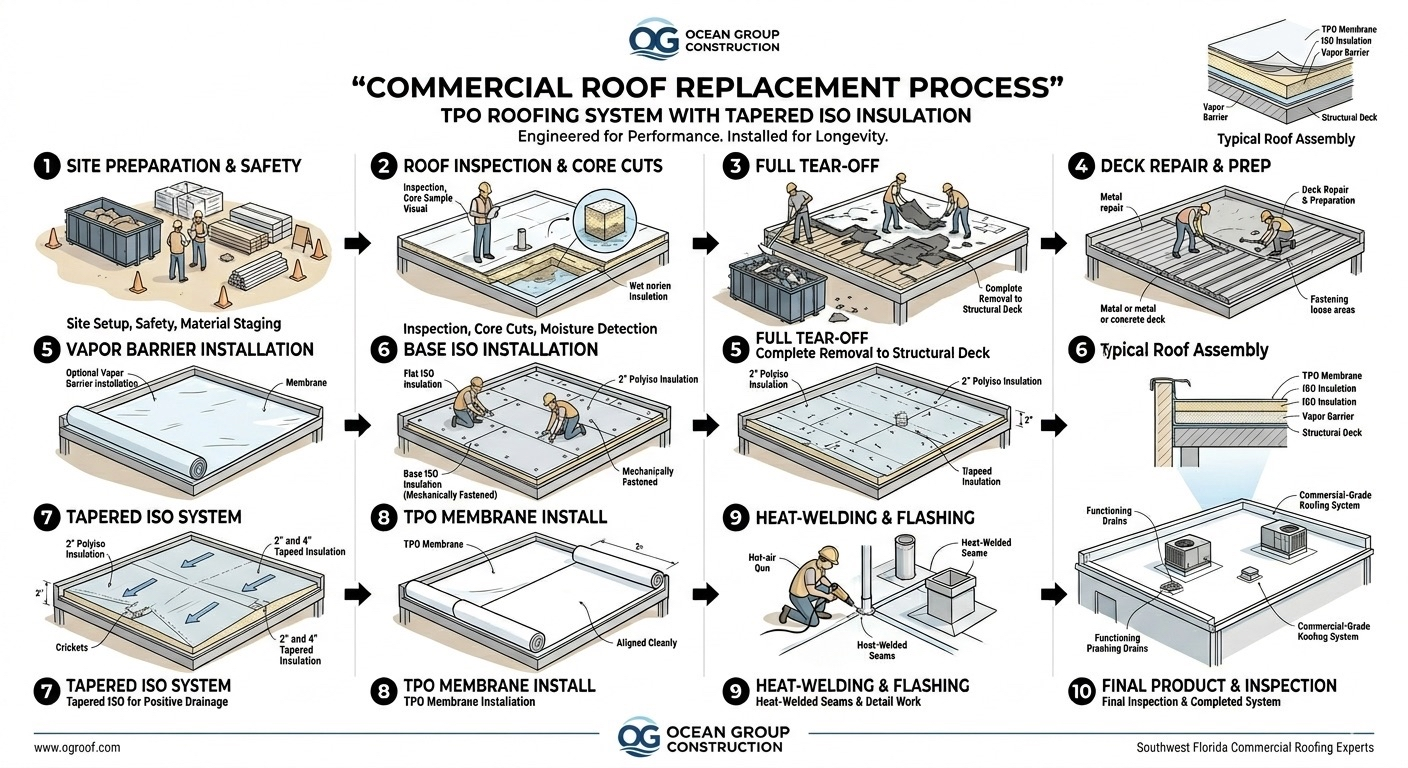

The Commercial Roof Replacement Process: Every Step, No Mystery
Published March 2026 · Ocean Group Construction
Commercial roof replacement follows a documented sequence, but the exact assembly, permits, inspections, phasing and schedule are project-specific.
Building owners and property managers deal with roof replacements infrequently and may have limited visibility into the field sequence. Not sure if your roof needs replacing? Read the signs it may be time to replace your commercial roof. The schedule depends on roof area, assembly, access, occupied operations, hidden conditions, inspections and weather.
Commercial Roof Replacement Process: The Direct Answer
A typical process moves from investigation and scope through site controls, removal or preparation, deck review, insulation and drainage, membrane and details, inspections, corrections, and closeout. Occupied buildings also need noise, access, weather, interior-protection and tenant coordination before work begins.
The proposal should identify assumptions, allowances, work zones, inspections, warranty path, closeout deliverables and conditions that can change the schedule.
The ten steps below describe a common workflow. The approved contract documents and field conditions control the actual project.
Step 1: Site Prep and Safety Setup
Before anyone steps on the roof with tools, we set up the job site. That means establishing material staging areas (keeping heavy materials off the roof until they're needed — concentrated loading on old deck is a bad idea), setting up debris drop zones, protecting roof penetrations and drains from debris contamination, and establishing safety protocols.
In Florida — from Fort Myers to Jacksonville — weather planning is part of the work sequence. Tear-off limits and temporary dry-in decisions are made from current conditions, forecast, crew capacity and the approved project plan. We also coordinate noise, dust, access and shared-area controls with occupants.
The time required varies by building and site controls. The important deliverable is a documented setup plan before destructive work begins.
Step 2: Roof Inspection and Core Cuts
Before tear-off, we do a systematic inspection and take core cuts. Core cuts are small plug samples cut through the entire roof assembly — membrane, insulation, and down to the deck — at representative locations across the roof. They tell us:
- How many existing layers are there (affects disposal load and sometimes code compliance)
- Whether the insulation is wet or dry
- What condition the deck is in
- What the existing assembly consists of (not always what the old specs said)
Core cut information can change the project scope. If we find wet insulation in unexpected areas, we expand the deck inspection plan. If the deck has corrosion or section loss, we budget deck repairs before proceeding. Surprises found during core cut review are manageable. Surprises found mid-tear-off are expensive emergencies. We find them early.
Step 3: Full Tear-Off
In Florida, the Florida Building Code generally requires a full tear-off rather than recovering over existing systems, particularly when the existing roof has wet insulation or when the new system would create more than two roof layers. Full tear-off means removing the existing membrane, all insulation layers, and any fill or leveling materials down to the bare structural deck.
This is often the loudest and dirtiest part of the project. Rotary tear-off tools cut through the existing system, and debris is controlled and moved to designated containers. Actual waste volume depends on the existing layers and materials.
Speed matters here — we move quickly to minimize the time the deck is exposed. In Florida's rainy season, we've had days where we tore off and got a temporary cover sheet down before 3 PM thunderstorms hit. That's not luck — it's planning.
Step 4: Deck Repair and Preparation
Once the deck is exposed, accessible areas are reviewed for rust, deterioration, attachment and surface conditions. Repair or replacement decisions follow the contract documents, field findings and any required design-professional direction.
Deck repair is billed as allowance work — we include a per-panel or per-square-foot rate in the contract because we can't know the full extent until the old system is off. In older Florida commercial buildings, deck repairs are common. UV, humidity, and hurricane cycles over 20-30 years take a toll.
The deck also gets cleaned of dust, adhesive residue, and any standing water before the next layer goes down. Clean, dry, flat deck is the non-negotiable starting point for everything that follows.
Step 5: Vapor Barrier Installation
A vapor retarder is included only when the approved assembly and hygrothermal design call for it. Climate, interior conditions, deck, insulation and system requirements must be evaluated for the specific building.
When specified, the selected vapor-retarder system is installed and detailed for continuity under the approved assembly requirements.
Step 6: Base ISO Installation
The first layer of polyiso insulation goes down on top of the vapor barrier. This base layer is full-thickness flat ISO — establishing the thermal performance of the assembly and providing the substrate for the tapered layer above. We use mechanically fastened ISO in most applications, with fasteners driven through the insulation and vapor barrier into the deck at engineered patterns.
Fastener patterns for insulation in Florida are not casual. They're calculated based on the same wind uplift forces as the membrane fastening — because the insulation has to stay attached under the same conditions the membrane faces. We use FM Global or manufacturer-engineered patterns and document the fastener type, length, and pattern for the project record.
Step 7: Tapered ISO System
This is where the drainage design becomes reality. The tapered ISO layer installs on top of the base ISO, transforming a flat substrate into a sloped drainage system. Every panel in a tapered ISO system is cut at a specific angle — typically 1/8" or 1/4" per foot — and laid out per the slope diagram developed during project engineering.
At every low point — every drain, every scupper — the ISO tapers to a minimum thickness (typically 1/2" or the minimum code-allowed thickness). From the drains, the panels angle upward toward the roof perimeter and ridges. At HVAC units and other obstructions, crickets and saddles divert water around equipment rather than letting it pool behind curbs.
A tapered layout can improve drainage when properly designed and installed. Read more about commercial roof drainage planning.
Step 8: TPO Membrane Installation
The TPO membrane rolls out over the tapered ISO in 10-foot or 12-foot wide sheets. We work from the low points toward the perimeter, unrolling and positioning sheets before fastening. Mechanically fastened TPO uses screws and plates driven through the membrane and insulation into the deck — the fastener rows become the overlaps for the next sheet, so they're covered and protected.
Sheet positioning matters. We maintain consistent overlap widths — typically 6 inches minimum — and ensure sheets are fully relaxed and temperature-acclimatized before welding. TPO that's installed cold and tight will wrinkle when it warms up. Wrinkles in field sheets create stress points. We get the membrane flat before it gets welded.
Step 9: Heat-Welding and Flashing
Seam welding runs concurrently with sheet installation. Automatic robotic welders run the field seams — calibrated to the ambient temperature and humidity, they maintain consistent weld temperature and speed across the entire roof. Every field seam gets probed after welding.
Detail work—HVAC curbs, pipe penetrations, parapet flashings, drain collars and edge metal—requires project-specific coordination. Detail density and complexity can materially affect schedule and labor.
Detail materials and reinforcement must follow the approved system, substrate preparation and manufacturer instructions. Our commercial roof detail guide explains why these transitions deserve close documentation.
Step 10: Final Product and Inspection
Before we call a project complete, we walk the entire roof systematically. Every seam, every detail, every penetration, every drain. We run a final probe check on any seams that were flagged during installation. We clear all debris from drain strainers and scupper boxes. We document the final condition with photos.
On manufacturer-warranted projects, required installation records are submitted under the applicable program. Inspection, correction and issuance requirements depend on the manufacturer and warranty document; issuance is not assumed until the manufacturer completes its process.
The building owner gets a complete project package: warranty documents, as-built installation records, maintenance recommendations, and photos of the finished system. Not a handshake and a signed permit. A record.
Timeline and Disruption
There is no universal replacement timeline. Roof area, assembly, tear-off, hidden deck conditions, access, occupied operations, inspections and weather all affect the schedule. The written proposal should state assumptions and sequencing.
For occupied buildings, tear-off limits and work zones are set for the building, weather plan and approved means and methods. Sensitive operations require a specific access, protection and contingency plan before work starts.
The goal is simple: get your building protected, get it done right, and get off your roof without drama. That's what 10 steps done correctly looks like. To understand what separates a rigorous installation from a cut-corner one, see our breakdown of good vs. bad commercial roof installation practices. And when you're choosing who does the work, our guide to choosing a commercial roofing contractor covers the questions to ask before signing a contract.
Before the process starts, use the commercial roof replacement cost-planning guide to normalize competing scopes. Boards can use the roof decision checklist to organize approvals, logistics, and closeout requirements.
Ready to talk about your building? Call or request an inspection below.
